NextGen FSM
2026 Wave Two 2026 Wave Three 2026 Wave One
2026 Wave Two 2026 Wave Three 2026 Wave One

Branch Configuration

The Branch configuration on which to execute the VRP Engine is a compulsory step of the VRP overall setting.

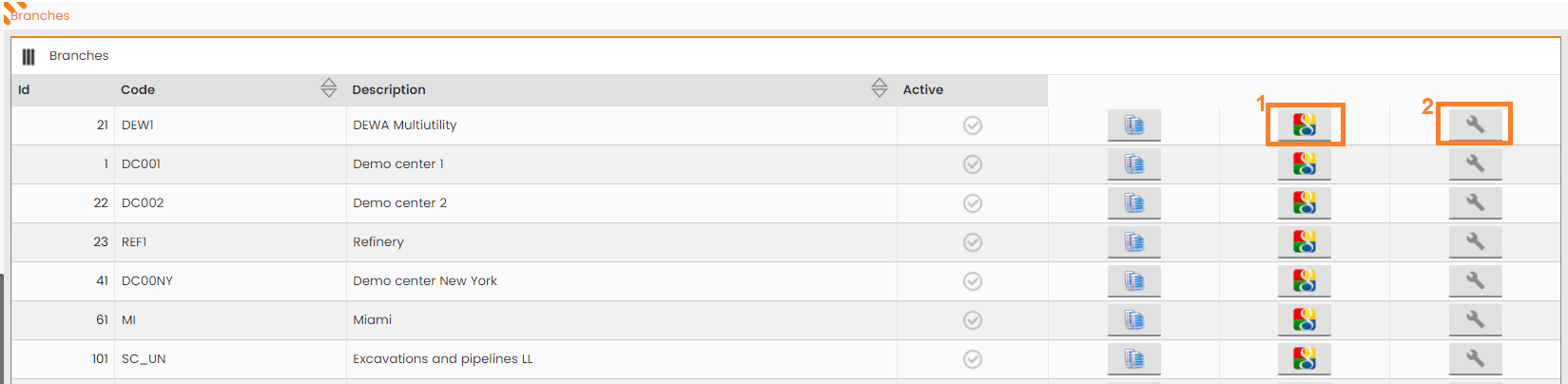

MAIN MENU → CONFIGURATION → SCHEDULING OPTIMIZATION → OPERATIONS CENTER


Figure - VRP Configuration for single OC

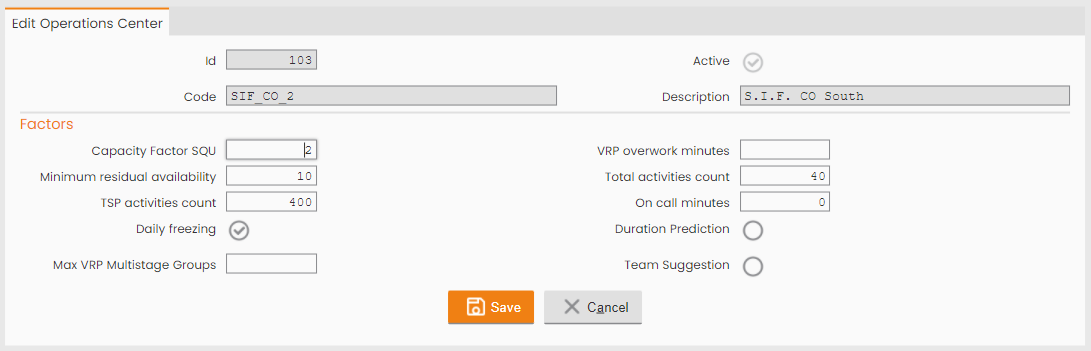

By clicking on the single Operation Center, several properties used in the VRP process have to be filled:



Figure - VRP Branch properties


Table AOPERATIONCENTER (all showed fields in the image above are in bold)

Column name

Description

AOCEID

PK

AOCEID_ACOM

company

AOCEDESCRIPTION

Description

AOCECODE

code

AOCEISACTIVE

flag active

AOCEPRIORITYFACTOR1

priority factor 1 - Not Used

AOCEPRIORITYFACTOR2

priority factor 2 - Not Used

AOCEPRIORITYFACTOR3

priority factor 3 - Not Used

AOCEPRIORITYFACTOR4

priority factor 4 - Not Used

AOCEPRIORITYFACTOR5

priority factor 5 - Not used

AOCECAPACITYFACTORINTRESOURCE

capacity factor internal resource - NOT USED

AOCECAPACITYFACTOREXTRESOURCE

capacity factor external resource - NOT USED

AOCECAPACITYFACTORTEAM

capacity factor team (Capacity Factor SQU)

AOCETERNARYACTIVITIESCOUNT

number of ternary activities - NOT USED

AOCEVRPADDEDACTIVITYCOUNT

(AFILOTTNUMATTCALCDIST) number of activities added by VRP - NOT USED

AOCEOPTSCHEDMINAVAIL

(AFILINTSQDISPMINSAT) minimum residual availability for VRP optimization and for optimization and integration

AOCEOPTADDEDACTIVITYCOUNT

(AFILINTSQNUMATTAGG) minimum number of tasks assigned for VRP optimization and for optimizing and integrating

AOCEOPTSPACTIVITYCOUNT

(AFILINTSQNUMATTCALCDIST) number of tasks taken from the TSP loading task for the resource optimization and integration process

AOCEOPTWORKDAYSCOUNT

NOT USED

AOCEINTTEAMSCHEDMINAVAIL

minimum team availability for Post-VRP optimization and for optimization and integration - NOT USED

AOCEINTTEAMADDEDACTIVITYCOUNT

minimum number of tasks assigned to the resource for Post-VRP optimization and for optimizing and integrating - NOT USED

AOCEINTTSPTEAMACTIVITYCOUNT

number of tasks taken from the TSP task for the optimization and integration process for teams - NOT USED

AOCEINTTEAMWORKDAYSCOUNT

not used

AOCEISSCHEDULINGACTIVE

active scheduling flag - NOT USED

AOCEISDAILYFREEZING

daily freezing flag. It allows to change (paste, remove) scheduling in the past

AOCEOSSOVERTIME

overtime/on call minutes allowed for the operational resources on the branch/operating center; default = 0 min.

AOCERTREPRADDEDACTIVITYCOUNT

number of updated activities reelaboration - NOT USED

AOCEADMITTEDOVERTIME

on call minutes allowed - NOT USED

DurationPrediction

Flag to enable Duration prediction AI feature

Max VRP Multistage Groups

Number of tasks to consider in the MST building

AOCEISTEAMSUGGESTIONENABLED

Team Suggestion flag to enable AI Team suggestion feature

By clicking on SPACE Button (Icon 1, Figure VRP configuration for single OC), the vehicle to be used by the scheduling Engine has to be defined:

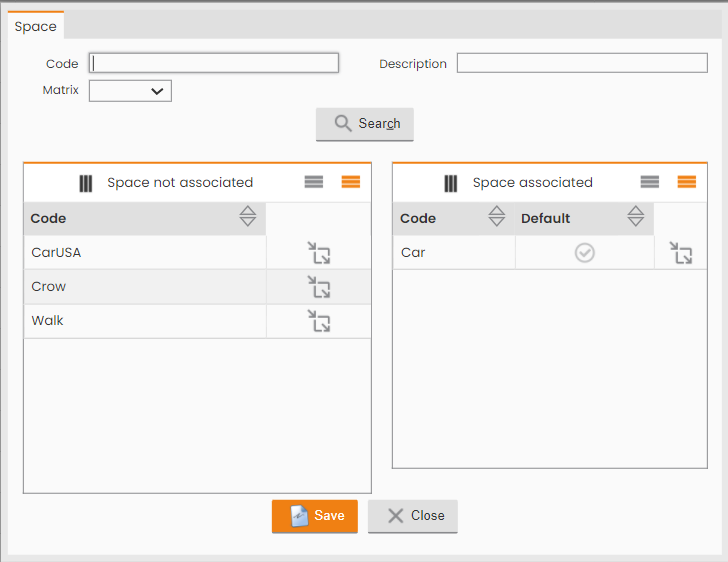

Figure - Vehicle to be used


By clicking on SCHEDULING Button (Icon 2, Figure VRP configuration for single OC), the VRP process to be used has to be defined:

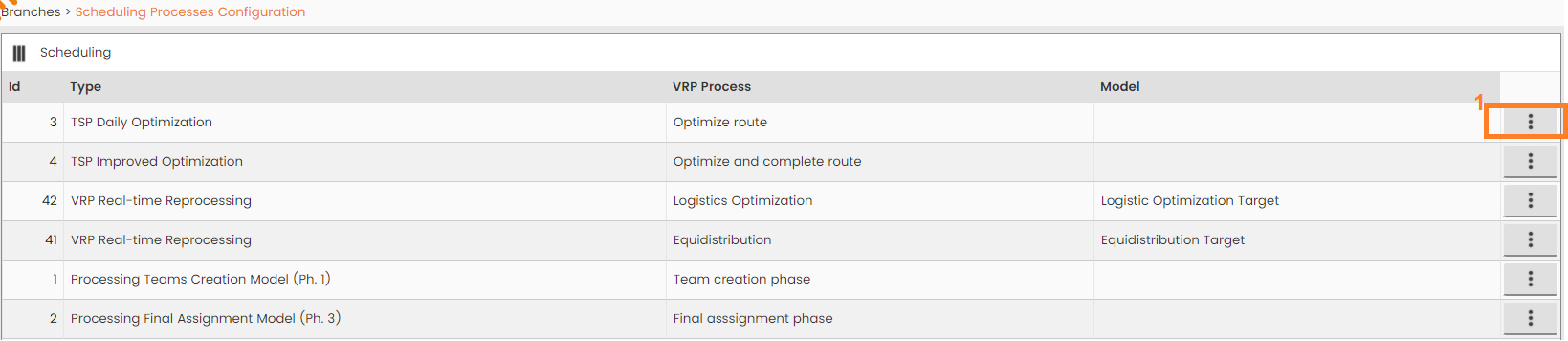

Figure - VRP process for the sigle Next-Gen FSM Platform functionality

Type: it indicates the Next-Gen FSM Platform functionality where to use VRP process.

  • TSP Daily Optimization: it allows to assign a VRP process to the ‘Optimize’ functionality of the Daily Plan;

  • TSP Improved Optimization: it allows to assign a VRP process to the ‘Optimize and Integrate’ functionality of the Daily Plan;

  • VRP Real-time Reprocessing: it allows to assign a VRP process to the Real-time process;

  • Processing Team Creation Model (Ph. 1): it allows to assign a VRP process to the first phase of virtual plan scheduling;

  • Processing Final Assignment Model (Ph.3): it allows to assign a VRP process to the third phase of virtual plan scheduling;

VRP process: VRP process to assign to the specific Next-Gen FSM Platform functionality;

Model: optional - specific scheduling Model to consider in the VRP process

By clicking on OPERATIONS button (icon1, Figure - VRP process for the sigle Next-Gen FSM Platform functionality), it’s possible to configure the VRP process to be used by all the Operation Centers.
